Comprehensive Analysis Clause 3.4 – Replacement of the Engineer

81 / 100 SEO Score

Views in the last 30 days: 63

Estimated read time: 7 minute(s)

🔁 Purpose of Clause 3.4 – Replacement of the Engineer

This clause governs the conditions and process by which the Employer may replace the Engineer. Since the Engineer plays a central role in contract administration, design reviews, certification, and dispute management, any replacement must ensure continuity and fairness.

Clause 3.4 ensures the Contractor is notified of any proposed replacement and allowed to object — particularly if neutrality or competence is at risk.

  • Protects Contractor from arbitrary or unsuitable changes
  • Ensures continuity, trust, and integrity in contract administration
  • Preserves procedural fairness and reduces potential bias

📘 Breakdown of Clause 3.4 – Replacement of the Engineer

FIDIC Yellow Book 1999 – Clause 3.4
“If the Employer intends to replace the Engineer, the Employer shall, not less than 42 days before the intended date of replacement, give notice to the Contractor of the name, address and relevant experience of the intended replacement. The Employer shall not replace the Engineer with a person against whom the Contractor raises reasonable objection by notice to the Employer, with supporting particulars.”

  • Minimum 42-day notice required.
  • Notice must include: Name, Address, Experience.
  • Contractor can object, but must provide solid reasoning.

FIDIC Yellow Book 2017 – Clause 3.4
The core intent remains, but refinements ensure tighter alignment with other clauses. Notice and objection rights are preserved — with formal notice under Clause 1.3 and explicit reference to fairness and competency.

  • Still uses 42-day advance notice and formal communication protocols.
  • Objection window clearly limited to 14 days.
  • Temporary appointments allowed in emergencies.
Step 1999 – Clause 3.4 2017 – Clause 3.6 Practical Effect
1️⃣ Employer issues notice ≥ 42 days before change, naming the new Engineer. Same 42 days notice, but includes address and relevant experience. Early disclosure lets Contractor run quick due-diligence.
2️⃣ Contractor may object “with supporting particulars”. Contractor must object within 14 days or deemed to accept. Tighter timeline → faster staffing decisions.
3️⃣ Employer must not appoint someone to whom Contractor raises reasonable objection. Same prohibition on unreasonable appointments. Keeps Engineer neutral & competent.
4️⃣ If Engineer cannot act (e.g., illness), temporary Engineer may be appointed immediately. Prevents project delays in emergencies.

🔍 Key Interpretations and Implications

✅ Right to Object: The Contractor’s ability to object safeguards against unqualified or biased appointments—ensuring the Engineer remains a neutral, competent authority under the contract.

❌ But Not a Veto: The objection must be based on reasonable grounds and documented with supporting details. It’s a shield, not a sword—no absolute power to reject at will.

📒 Clarified in 2017: FIDIC’s 2017 edition preserves the same right but frames it more clearly using formal notice protocols (Clause 1.3). This reflects FIDIC’s “Golden Principle” of fair and transparent risk allocation.

⚠️ Risks of Poor Replacement: An unsuitable Engineer could stall quality checks, certifications, and create dispute bottlenecks. Abrupt or politically influenced changes can undermine project momentum and trust.

✍️ Suggestions for Clarity and Improvement

🔍 A. Identifying Potential Ambiguities

  • Reasonable Objection” is undefined — What counts as reasonable?
  • No standard for qualifications or language fluency.
  • No provision for interim Engineer in case of sudden resignation.
  • No mandatory consultation with the Contractor before decision.

💡 B. Practical Examples That Demand Better Wording

📌 Example 1: The Employer proposes a marine specialist for an MEP project. The Contractor objects—but “technical fit” isn’t defined.
📌 Example 2: The proposed Engineer has prior business with the Employer’s legal team. Without a stated policy, objections become subjective.

🔧 C. Suggested Wording – Golden Principles Compliant 🟢

Here’s a suggested Particular Conditions version of Clause 3.4, written to pass the FIDIC Golden Principles (GP1–GP5):

Sub-Clause 3.4 [Replacement of the Engineer] – Amended

If the Employer intends to replace the Engineer, the Employer shall, not less than 42 days before the intended date of replacement, give a Notice to the Contractor of the name, address, and relevant qualifications and experience of the proposed replacement.

The replacement Engineer shall:
(a) have not less than 15 years of relevant professional experience, with 5 in similar project environments;
(b) be fluent in the ruling language as defined in Sub-Clause 1.4;
(c) have had no direct commercial or advisory relationship with either Party in the past 3 years;
(d) meet the standards required in Sub-Clause 3.1.

The Contractor shall, within 14 days of receiving the Notice, submit a Notice of objection with reasonable grounds. These may include: lack of competence, conflict of interest, insufficient experience, or language barriers.

Failure to respond within 14 days shall be deemed acceptance.

If the Engineer resigns, is incapacitated, or dies, the Employer may appoint an interim Engineer for up to 30 days with immediate notice. The permanent process shall still follow this Sub-Clause.

No replacement shall take effect unless all conditions above are satisfied.

💬 Why This Works: The GP Compliance Test ✅

Element FIDIC Golden Principle Why It Passes
Minimum qualifications & neutrality GP1, GP3 Clarifies duties & preserves balance
Defined “reasonable objection” GP2 Removes ambiguity with objective triggers
Interim appointment provision GP1, GP4 Handles sudden exits without project freeze
42-day notice retained GP4 Upholds the original tested timeline
Language fluency clause GP1 Ensures Engineer’s ability to interpret and act effectively

✉️ Clause 3.4 / 3.6 Letter Scenarios – Sample Templates

📬 Scenario 1 – Employer’s 42-Day Notice of Proposed Replacement
[Employer’s Letterhead]

Our Ref: _______            Date: ___ ______ 20__
To: [Contractor’s Name & Address]

Contract: [Project title, Contract No.]
Subject: Notice of Proposed Replacement of the Engineer under Clause 3.4 (1999) / 3.6 (2017)

Dear Sirs,

Pursuant to Clause 3.4 / 3.6, we hereby give you notice of our intention to replace the Engineer.

1. Proposed Engineer: [Full legal name]
2. Address for correspondence: [Postal & e-mail]
3. Relevant experience (summary CV enclosed): ▢
4. Effective date of appointment: [dd mmm yyyy] (not earlier than 42 days from the date of this notice).

Please review the above nomination and advise us of any reasonable objection within the period specified in the Contract.

Yours faithfully,

[Authorised signatory]
for and on behalf of the Employer
Attachments: CV, key project references, organisational chart (optional)
🛑 Scenario 2 – Contractor Objects (within 14 days – 2017)
[Contractor’s Letterhead]

Our Ref: _______            Date: ___ ______ 20__
To: [Employer’s Name & Address]

Contract: [Project title, Contract No.]
Subject: Objection to Proposed Replacement of the Engineer – Clause 3.6 (2017)

Dear Sirs,

We refer to your letter dated [dd mmm yyyy] regarding the proposed appointment of [Name] as Engineer.

Under Clause 3.6(b), we must raise our reasonable objection as follows:

1. Conflict of interest – Nominee currently engaged by [Company] advising the Employer
2. Lack of design-build experience – CV shows <5 years on comparable EPC projects
3. Pending arbitration – Nominee involved in [XYZ] Project with our group entity

We respectfully request the nomination of an alternative Engineer in accordance with the Contract.

Yours faithfully,

[Authorised signatory]
for and on behalf of the Contractor
✅ Scenario 3 – Contractor No-Objection / Acceptance
[Contractor’s Letterhead]

Our Ref: _______            Date: ___ ______ 20__
To: [Employer’s Name & Address]

Contract: [Project title, Contract No.]
Subject: Acceptance of Proposed Replacement of the Engineer – Clause 3.4 / 3.6

Dear Sirs,

We acknowledge receipt of your notice dated [dd mmm yyyy] naming [Name] as the proposed new Engineer.

Having reviewed the submitted credentials, we raise no objection under Clause 3.4 (1999) / 3.6 (2017).
Please confirm the effective hand-over date and arrange a briefing meeting on programme, variations, and determinations.

Yours faithfully,

[Authorised signatory]
for and on behalf of the Contractor
🚨 Scenario 4 – Employer’s Emergency Temporary Appointment (2017 only)
[Employer’s Letterhead]

Our Ref: _______            Date: ___ ______ 20__
To: [Contractor’s Name & Address]

Contract: [Project title, Contract No.]
Subject: Temporary Appointment of Engineer – Clause 3.6(d) (2017)

Dear Sirs,

We regret to inform you that the current Engineer, [Name], is no longer able to act due to [reason].

In accordance with Clause 3.6(d), we hereby appoint, on a temporary basis, [Interim Engineer’s Name] of [Company] to perform the Engineer’s duties with effect from today.

Please cooperate fully with the Interim Engineer to prevent disruption to the Works.

Yours faithfully,

[Authorised signatory]
for and on behalf of the Employer
⚖️ Scenario 5 – Contractor Cost / Time Claim for Non-Compliant Replacement
[Contractor’s Letterhead]

Our Ref: _______            Date: ___ ______ 20__
To: [Employer’s Name & Address]

Contract: [Project title, Contract No.]
Subject: Notice of Claim – Breach of Clause 3.4 / 3.6 (Unnotified Replacement)

Dear Sirs,

We record that on [dd mmm yyyy], the Employer introduced [Name] as Engineer without prior notice required under Clause 3.4 (1999) / 3.6 (2017).

This has disrupted progress meetings and delayed determinations under Clause 3.7.

We therefore give Notice of Claim under Clause 20.1 (1999) / 20.2 (2017) for:

- EOT of [x] days
- Cost plus Profit estimated at [currency] [amount]

Yours faithfully,

[Authorised signatory]
for and on behalf of the Contractor

🔑 Tips for Using These Templates

Step Key Check-Point Reminder
📌 1 Quote the right clause and edition Distinguish between 3.4 (1999) and 3.6 (2017)
📌 2 Track the notice dates Use a tracker for the 14-day / 42-day windows
📌 3 Attach evidence to your objection CVs, conflicts, programme impacts – be persuasive
📌 4 Mirror letters to all parties if needed Send to Employer, Contractor, and Engineer

🏗️ Employer — 42-Day Notice & Nomination Steps

#Action ItemClauseBookTiming / Period
1Draft formal notice naming the proposed Engineer3.4 / 3.6 (a)1999 / 2017≥ 42 days before appointment
2Attach CV showing relevant design-build/EPC experience3.6 (a)(ii)2017With the notice
3State contact address, e-mail & phone of nominee3.6 (a)(iii)2017With the notice
4Copy the notice to the current Engineer (if still in post)Good practiceBothImmediately
5Note calendar reminder for end of objection window3.6 (b)2017Day 0 + 14
6File proof-of-delivery to ContractorContract adminBothDay 0

🛠️ Contractor — Review & Objection Window

#Action ItemClauseBookTiming / Period
1Log date/time notice received1.3 (Notices)BothOn receipt
2Circulate CV for internal conflict & competence review3.4 / 3.6BothWithin 3 days
3Consider external due-diligence checkRisk mgmt.BothWithin 7 days
4Decide if grounds for “reasonable objection” exist3.4 / 3.6 (b)BothBy Day 12 / promptly
5Draft objection letter with evidence (if needed)3.4 / 3.6 (b)BothBy Day 14 (2017)
6If no objection, send acceptance & request hand-overSameBothBefore Day 14
7Update claim tracker if notice non-compliant20.1 / 20.2BothOngoing

⚡ Emergency / Temporary Engineer (2017-Only)

#Action ItemClauseTiming
1Employer issues immediate notice for temporary Engineer3.6 (d)Day 0 (event)
2Share credentials & contact of interim appointee3.6 (d)Day 0
3Inform Contractor that full nomination will follow3.6 (d)With notice
4Keep separate audit trail for interim decisionsBest practiceContinuous
5Initiate 42-day nomination process for permanent Engineer3.6 (a–c)Within 14 days
6Update programme/risk logs for disruptionPMOOngoing

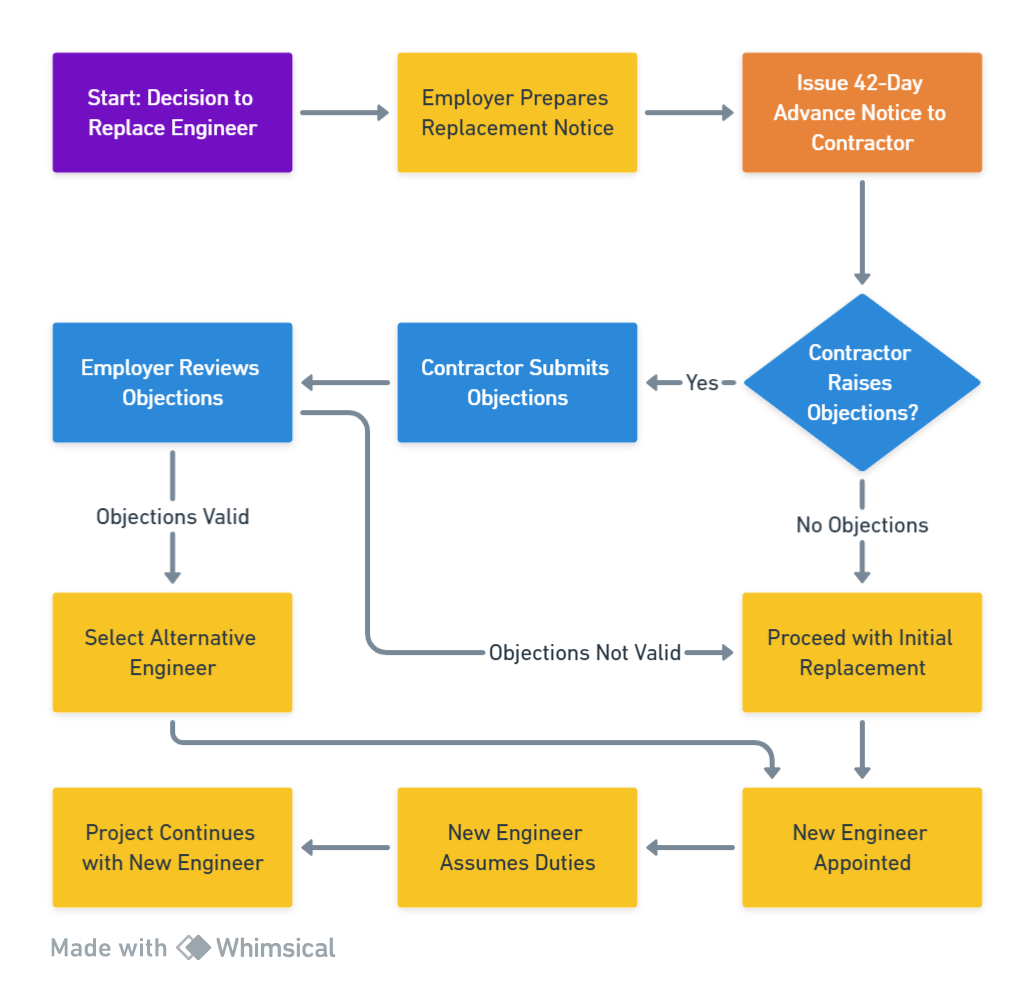

📊 Flowchart: Engineer Replacement Process under FIDIC 1999

Flowchart Replacement of Engineer FIDIC 1999
Click to view full-size flowchart – visual summary of Clause 3.4 (FIDIC 1999)
  • Start: Employer decides to replace the Engineer.
  • Prepare Notice: Full details of replacement Engineer drafted.
  • Issue 42-Day Notice: Sent to Contractor in advance.
  • Contractor Decision Point: Review and raise objection if needed.
  • Submit Objections: Contractor provides reasons + documentation.
  • Employer Review: Objections assessed for merit.
  • Outcome:
    • ✔️ Valid objection → Select new Engineer
    • ✔️ No objection or invalid → Proceed with original choice
  • Engineer Appointed: Formal appointment confirmed.
  • Duties Begin: New Engineer takes over.
  • Project Continues: Progress resumes under new Engineer.
💡 Pro Tip: This flow is based on FIDIC 1999 Clause 3.4. For 2017 contracts, remember the 14-day objection deadline and provisions for temporary appointments under Clause 3.6(d).

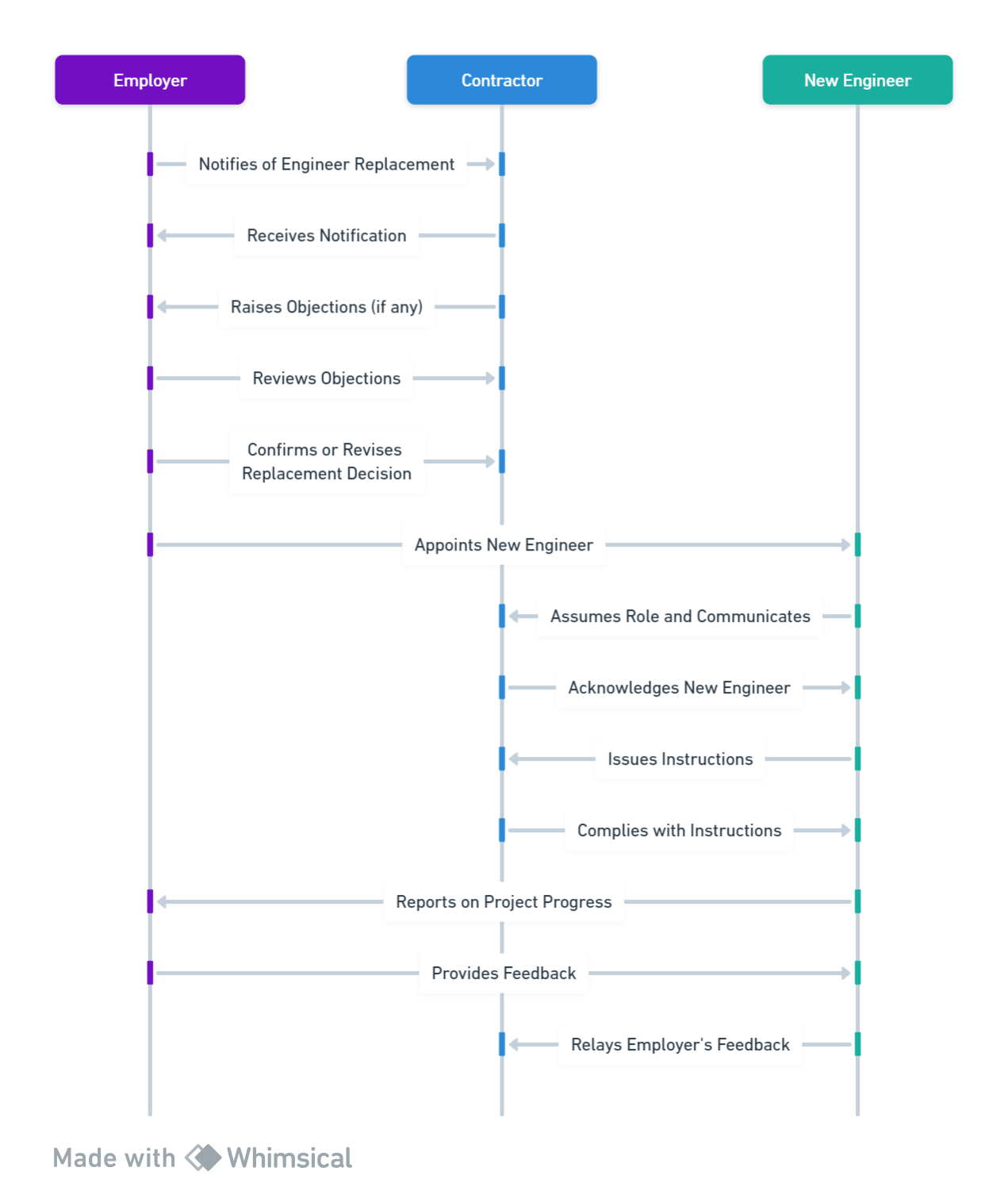

📈 Sequence Diagram: Engineer Replacement Steps in FIDIC 1999

Sequence Diagram of Engineer Replacement in FIDIC 1999
Click to view full-size sequence diagram — shows the communication & action chain in Clause 3.4 (1999)
  • Employer Notifies Contractor of intention to replace Engineer (with full details).
  • Contractor Receives Notice and begins assessing proposed Engineer.
  • Contractor Raises Objections (if any), citing reasonable grounds.
  • Employer Reviews the Contractor’s objections to assess validity.
  • Employer Confirms or Revises the nomination based on objections.
  • Employer Formally Appoints the new Engineer.
  • New Engineer Assumes Role and initiates communication.
  • Contractor Acknowledges and prepares to receive instructions.
  • Engineer Issues Instructions to continue the project smoothly.
  • Contractor Complies with instructions and resumes work.
  • Engineer Reports progress to Employer regularly.
  • Employer Reviews and gives feedback or directives.
  • Engineer Relays Feedback back to the Contractor for execution.
💡 Tip: This sequence shows how the replacement affects **not just approval**, but ongoing communication and operational flow. It complements the flowchart overview by focusing on **message sequencing and response logic**.
