FIDIC Clause 4.12: Unforeseeable Physical Conditions Explained

80 / 100 SEO Score

Views in the last 30 days: 208

Estimated read time: 12 minute(s)

Why Clause 4.12 Matters 🚧
Imagine this: You’re deep into building a wastewater plant or a substation when—bam!—your excavator hits a solid rock layer *nobody* saw coming.
That’s where Clause 4.12 steps in as your site bodyguard.
ā›‘ļø
Surprise Site Conditions?
Clause 4.12 gives contractors a way to claim extra time and money if you uncover something hidden beneath the surface—literally.
āš ļø
It recognizes that no amount of pre-bid research can reveal *every* site risk, especially on complex jobs. Think deep rock, old foundations, or mystery pipes.
šŸ“„
This clause lives in Section 4: The Contractor, because it’s all about the *risks you bear* when building.
It works alongside Clause 4.10 (Site Data) and 4.11 (Sufficiency of the Contract Amount) to cover the full spectrum of ā€œwhat ifā€ scenarios.
šŸ’” The Twist: Clause 4.12 is about relief, not more responsibility. When you hit the unexpected, you don’t just carry the cost—Clause 4.12 opens the door to fair adjustments.
šŸ”Ž Want the deep dive? Explore the full analysis on Unforeseeable Physical Conditions – Clause 4.12 [Related Guide]
šŸ•°ļø HISTORICAL CONTEXT: 1999 vs. 2017 Edition – What’s New and Why?
1999
1999: The clause was straightforward—but vague. Contractors had to notify the Engineer ā€œas soon as practicable,ā€ with no real process or timeline. This left a lot open to interpretation (and dispute) about what counted as ā€œsoon enough.ā€
ā€œIf the Contractor encounters adverse physical conditions which he considers to have been Unforeseeable, the Contractor shall give notice to the Engineer as soon as practicable. This notice shall describe the physical conditions, so that they can be inspected by the Engineer.ā€
2017
2017: FIDIC got smarter—clarity means fewer disputes! Now Clause 4.12 is split into five clear steps, spelling out:
  • When you must notify
  • What the Engineer must do
  • How claims are calculated
  • When and how they’re determined
The process now directly refers to Clause 20.2 (claims & disputes)[Explore Clause 20.2], giving you a clear legal roadmap if things go wrong underground.
šŸš€ What’s Improved?
More transparency. Less fighting. The new approach means everyone knows the rules upfront—less room for ā€œhe said, she saidā€ arguments.
Connected claims process. The tie-in with Clause 20.2 ensures contractors know exactly how to make a claim and what timelines apply.
🧱 CLAUSE BREAKDOWN (FIDIC 2017 STYLE – STEP BY STEP)
šŸ”ø Sub-Clause 4.12.1 – Contractor’s Notice
ā€œIf the Contractor encounters adverse physical conditions which he considers to have been Unforeseeable, the Contractor shall give a Notice to the Engineer as soon as practicable and describe in such Notice the physical conditions, giving reasons why he considers them Unforeseeable and setting out the anticipated effects of those conditions on progress and/or the Contractor’s Cost.ā€
What it means: As soon as you hit something unexpected in the ground—something you couldn’t reasonably anticipate—you have to let the Engineer know, formally and in writing.
  • A clear description of the condition (e.g., unexpected rock, debris, groundwater)
  • Why it’s ā€œunforeseeableā€ (support with bore logs, reports, tender drawings)
  • How it may affect your progress and/or cost
This formal notice is the key that unlocks the whole claims process under Clause 4.12. Without it, you can’t get time extensions or cost recovery—even for a totally legitimate issue. FIDIC emphasizes transparency and fairness: no official notice, no claim.

Your notice isn’t just a courtesy; it’s a contractual lifeline. It triggers site visits, instructions, and maybe variations. If it’s late, vague, or missing, your claim might be rejected before it’s even reviewed. Protect your rights: treat this notice as the critical first step.
šŸ”ø Sub-Clause 4.12.2 – Engineer’s Inspection and Investigation
ā€œThe Engineer shall, upon receiving such Notice, proceed to inspect and investigate these physical conditions within 7 days after receiving the Notice, or within such other period as may be agreed.ā€
What it means: The Engineer must come to site within 7 days (unless you both agree otherwise) to inspect and investigate what you’ve found. It’s about verifying the facts on the ground—no more ā€œjust take my word for it.ā€
This step is FIDIC’s way of saying ā€œTrust, but verify.ā€ The Engineer has to see the issue for themselves—no more decisions made in the office, sight unseen. It grounds the conversation in reality, reduces exaggeration, and builds mutual trust.

Direct engagement helps avoid disputes later. Like a referee watching the play, the Engineer’s presence ensures any call is based on facts, not paperwork or guesswork.
šŸ”ø Sub-Clause 4.12.3 – Engineer’s Instructions
ā€œIf and to the extent that the Engineer determines that the physical conditions encountered were Unforeseeable, the Engineer may issue instructions under Sub-Clause 13.3.1 [Variation by Instruction].ā€
What it means: If the Engineer agrees the physical condition was truly unforeseeable, they can issue instructions right away to keep the project moving. Sometimes it’s a small fix (dig deeper), sometimes a bigger change (redesign).
Construction can’t pause for paperwork. This clause is a project ā€œgreen lightā€ā€”the Engineer gives practical instructions so boots stay on the ground, machines keep moving, and you avoid delays. The formal claim is still running in the background, but work doesn’t have to stop.

That flexibility is a lifesaver on fast-track jobs. Small surprises stay small, and you avoid a domino effect of delays.
šŸ”ø Sub-Clause 4.12.4 – Delay and/or Cost
ā€œThe Contractor shall be entitled subject to Sub-Clause 20.2 [Claims for Payment and/or Extension of Time] to: (a) an extension of time for any delay, and/or (b) payment of any Cost, which shall be included in the Contract Price,ā€
What it means: The Contractor can get more time, more money, or both—but only if the rules in Clause 20.2 are followed exactly. That means timely notice, detailed breakdowns, and zero shortcuts.
Clause 20.2 isn’t just a guideline—it’s the *rulebook* for claims. Miss a deadline, skip a detail, or submit a vague breakdown and you risk losing a valid claim, even if your situation is justified.

Always treat Clause 4.12 as your first step, but remember: Clause 20.2 is the critical bridge to actual time or money.
šŸ”ø Sub-Clause 4.12.5 – Agreement or Determination
ā€œThe Engineer shall proceed in accordance with Sub-Clause 3.7 [Agreement or Determination] to agree or determine: (a) whether and to what extent the physical conditions were Unforeseeable; (b) the extension of time (if any) to which the Contractor is entitled; (c) the amount of Cost (if any) to which the Contractor is entitled.ā€
What it means: The Engineer formally decides (or both sides agree) how much time and/or money is actually owed. And—importantly—favorable site conditions can be considered too, for a fair, balanced outcome.
This is about *balance*. If unexpected problems slow you down and cost extra, you get compensated. But if you hit unexpectedly easy conditions elsewhere, those ā€œbonusesā€ get factored in too. The goal: fair risk-sharing, not cherry-picking only the tough bits.

Especially on big, complex jobs, this grown-up approach keeps everyone honest—and helps prevent disputes down the road.
šŸ› ļø REAL-LIFE EXAMPLE: U.S. Construction Context
šŸ“„
You’re on a California school campus. Digging utility trenches, you hit an old concrete slab—totally absent from all site data.
šŸ“Ø
You send a detailed notice to the Engineer, explaining why the slab wasn’t foreseeable.
šŸ‘·ā€ā™‚ļø
The Engineer arrives within 7 days, documents the slab (photos, measurements).
šŸ“
Instructions are issued: ā€œRemove and dispose of the slab; we’ll adjust your schedule.ā€
ā³
You follow those instructions and later submit a formal claim under Clause 20.2 for extension of time and additional cost.
šŸ‡ŗšŸ‡ø U.S. Comparison: This process aligns closely with ā€œDiffering Site Conditionsā€ clauses in U.S. contracts (like FAR 52.236-2), but FIDIC puts a stronger emphasis on Engineer oversight and procedural fairness—a more European touch.[FAR 52.236-2 Reference]
šŸ”„ INTERACTING CLAUSES – THE CLAUSE 4.12 WEB
Clause 4.12 (Unforeseeable Physical Conditions)
šŸ—ŗļø Clause 4.10: Site Data [Guide]
Sets the baseline for what the Contractor is ā€œdeemed to knowā€ before work starts. Clause 4.12 steps in if even a diligent review can’t reveal certain surprises.
ā³ Clause 20.2: Claims [How Claims Work]
This clause is the engine room for all claims—timelines, notices, and substantiation. Missing a step here can sink even a valid claim under 4.12.
šŸ¤ Clause 3.7: Engineer’s Decision [Resolution Process]
Lays out how the Engineer must seek agreement—or make a decision—on claims, with deadlines to prevent your claim from disappearing into a black hole.
āš ļø CHALLENGES & SOLUTIONS
Challenge: Many contractors delay notifying, hoping to ā€œfix it on the fly.ā€ Later, their claim is denied for being late.
Solution: Train field engineers to escalate unknown conditions immediately—even before knowing the full cost impact.
Challenge: ā€œUnforeseeableā€ to the Contractor may look ā€œreasonableā€ to the Engineer.
Solution: Use the Base Date and all tender documentation to benchmark foreseeability. Even better, propose a Geotechnical Baseline Report (GBR) to define what’s expected—and what’s not—upfront.
šŸ” COMPARATIVE ANALYSIS
Contract Approach
FIDIC Yellow 2017 Structured, detailed, and fair; emphasizes prompt notice and risk balance
NEC4 ECC More collaborative but less precise about ā€œunforeseenā€
AIA A201 Addresses concealed conditions but relies heavily on U.S. case law
FAR (U.S. Gov’t) ā€œDiffering Site Conditionsā€ clause (Type I/II) is robust but process can be very formalistic
šŸ—‚ļø Sample Site Risk Allocation Matrix
Risk Item Description Party Responsible Comments / Basis
Subsurface Conditions Soil type, rock layers, groundwater Employer (except unforeseeable) Contractor relies on site data per Clause 4.10. Unforeseeable issues may trigger 4.12.
Contamination / Hazardous Materials Asbestos, oil, heavy metals Employer Unless Contractor contributed or it was obvious during tender site visit.
Utility Locations (Known) Water, gas, power (per utility surveys) Employer Data expected from Employer. Contractor can rely on its accuracy.
Utility Locations (Unknown) Buried/unmapped services Shared Typically unforeseeable; subject to 4.12 if not reasonably discoverable.
Archaeological Finds Ruins, artifacts, fossils Employer Treated under Clause 4.23. Work may be suspended.
Weather / Climatic Conditions Rainfall, temperature extremes Contractor Considered foreseeable unless truly exceptional (Clause 18 – Exceptional Events).
Traffic / Access Restrictions Limited road use, load limits Employer Especially if restrictions are due to local regulations unknown at tender.
Site Access / Rights of Way Land acquisition delays, 3rd-party access Employer Clause 2.1 obligates Employer to provide access.
Existing Structures Integrity of nearby buildings Shared Contractor protects; Employer must disclose known risks.
Site Topography Slopes, flood risk, erosion Contractor Generally observable and thus foreseeable.
UXO (Unexploded Ordnance) Landmines, shells, military waste Employer Unforeseeable and high-risk. May be Exceptional Event.
Groundwater Behavior Seepage, seasonal variation Shared Some foreseeable; deep aquifers may qualify for 4.12.

āœ… Clause 4.12 Compliance & Risk Management Checklist

šŸ” Pre-Construction / Tender Stage

🚧 Site Conditions Monitoring (During Construction)

šŸ“¢ Notice Procedure – Clause 4.12.1

šŸ•µļøā€ā™‚ļø Engineer’s Investigation – Clause 4.12.2

šŸ“œ Engineer’s Instructions – Clause 4.12.3

šŸ“„ Claim Filing (Clause 4.12.4 + Clause 20.2)

āš–ļø Engineer’s Determination – Clause 4.12.5

šŸ“š Records & Documentation

🚧

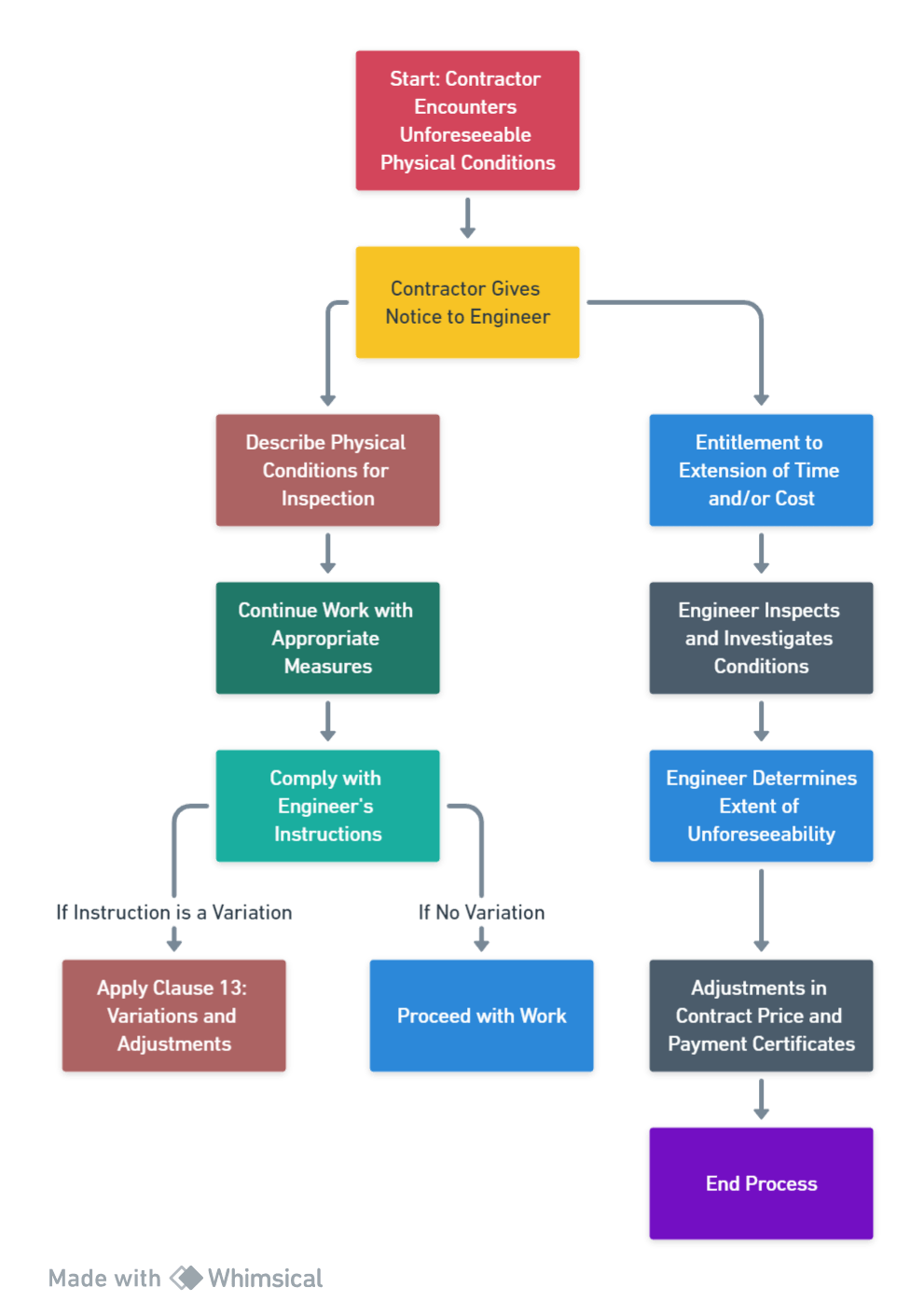

Start: Contractor Encounters Unforeseeable Physical Conditions
Contractor finds unexpected natural or man-made site conditions (e.g., hidden sub-surface structures, odd groundwater).
šŸ“Ø
Contractor Gives Notice to Engineer
Prompt written notice to Engineer starts the process and documents the conditions.
šŸ“
Describe Physical Conditions for Inspection
Contractor details the conditions for the Engineer’s inspection and for any future claims.
šŸ”„
Continue Work with Appropriate Measures
Contractor keeps working, using best methods to manage the situation, showing project commitment.
āœ…
Comply with Engineer’s Instructions
Contractor follows any instructions given in response to the conditions.
šŸ”€
If Instruction is a Variation
If instructions change the scope significantly, Clause 13 (Variations) applies.
šŸ—ļø
Proceed with Work
If not a variation, work continues as originally planned, incorporating minor adjustments.
šŸ’°
Entitlement to Extension of Time and/or Cost
Contractor may claim extra time/payment (per Sub-Clause 20.1), if justified by the unforeseen conditions.
šŸ”
Engineer Inspects and Investigates Conditions
Engineer reviews the reported conditions and impact on the project.
šŸ§‘ā€āš–ļø
Engineer Determines Extent of Unforeseeability
Engineer decides what was truly unforeseeable and the impact on entitlements.
šŸ“Š
Adjustments in Contract Price and Payment Certificates
Engineer adjusts contract value/payment, considering both difficult and favorable conditions for fairness.
šŸ
End Process
Once everything’s evaluated, the process closes and the project continues.

šŸ“ˆ See the Visual Flowchart

Open Full Flowchart šŸ”— Clause 4.12 Flowchart
šŸ“© Sample Letters for Clause 4.12 (FIDIC 2017)
Subject: Notice Under Sub-Clause 4.12.1 – Unforeseeable Physical Conditions Encountered at [Location]

Dear [Engineer’s Name],

Pursuant to Sub-Clause 4.12.1 of the Conditions of Contract, we hereby notify you that we have encountered physical conditions at the Site which we consider to be Unforeseeable.

Details of Conditions:
On [insert date], during excavation at [location], we encountered [e.g., a dense basalt rock layer at 2.5 meters depth], which differs materially from the site investigation reports provided at Tender stage.

Why Unforeseeable:
These conditions were not identified in the geotechnical reports made available prior to the Base Date and could not have been reasonably anticipated by an experienced contractor exercising due diligence.

Impacts:

  • Additional excavation time and equipment
  • Disruption to our construction schedule
  • Increased costs
We respectfully request that you proceed to inspect and investigate the conditions as per Sub-Clause 4.12.2.

Yours faithfully,
[Name]
[Position]
[Contractor’s Company Name]

Subject: Instruction Pursuant to Sub-Clause 4.12.3 – Unforeseeable Physical Conditions

Dear [Contractor’s Name],

Following your Notice dated [insert date] regarding the unforeseen physical conditions at [location], we confirm that we have inspected the Site in accordance with Sub-Clause 4.12.2.

Based on our investigation, we determine the condition is considered Unforeseeable and falls within the scope of Sub-Clause 4.12. Accordingly, you are instructed to proceed as follows (per Sub-Clause 13.3.1 [Variation]):

[Instruction, e.g., Excavate using rock breakers and dispose material off-site]
[Any temporary support measures]
[Updated sequencing to accommodate delay]

Please proceed accordingly and record all associated impacts to cost and progress for evaluation under Clause 20.2.

Yours sincerely,
[Engineer’s Name]
[Title]
[Employer or Consultant’s Company Name]

Subject: Submission of Claim under Sub-Clauses 4.12 & 20.2 – Delay and Cost Due to Unforeseeable Physical Conditions

Dear [Engineer’s Name],

Further to our Notice dated [insert date] and your instruction dated [insert date] regarding the Unforeseeable Physical Conditions at [location], we hereby submit our formal Claim for:

  • Extension of Time under Sub-Clause 8.5
  • Payment of Cost per Sub-Clauses 4.12.4 and 20.2.1
Supporting Documents Enclosed:
  • Description of the events and physical conditions encountered
  • Justification of why the conditions were unforeseeable
  • Photographic and documentary evidence
  • Impact on program and revised critical path
  • Breakdown of additional costs (equipment, labor, disposal, etc.)
We respectfully request this Claim be reviewed and determined in accordance with Sub-Clauses 20.2.5 & 3.7.

Should you require additional details or site clarifications, please let us know.

Yours faithfully,
[Name]
[Position]
[Contractor’s Company Name]
