Loading

Advance Payment
Advance Payment
FIDIC Clause 14.2 — Advance Payment Configurator
Generate tailored Particular Conditions and a repayment/APG step-down schedule. Outputs appear only after you click Generate.

Contract inputs

Enter numeric amount (in base currency). Multicurrency splits are set below.
Typical range: 10–20%. If >22%, consider higher deduction rates.
You can describe tranche conditions below.

Repayment mechanics

Default is 10% under both 1999/2017.
Default is 25% under both 1999/2017.
If set, kicks in after outstanding ≤ threshold below.
When outstanding falls to this % of ACA, switch to stage-2 rate.
2017 default is 21 days (Sub-Clause 14.7).
Good practice: 14–28 days from LoA (align with 4.2 PS timing).

Multicurrency composition

Proportions should sum to ~100% (small rounding drift is auto-normalized for simulation). Repayments mirror these proportions under 14.2.

Payment plan (for simulation)

Tranche descriptions (optional, for PCs)

Defaults: trigger 10%, deduction 25%, pay period 21 days APG: extend ≥ 28 days pre-expiry; Employer may call if no evidence ≥ 7 days

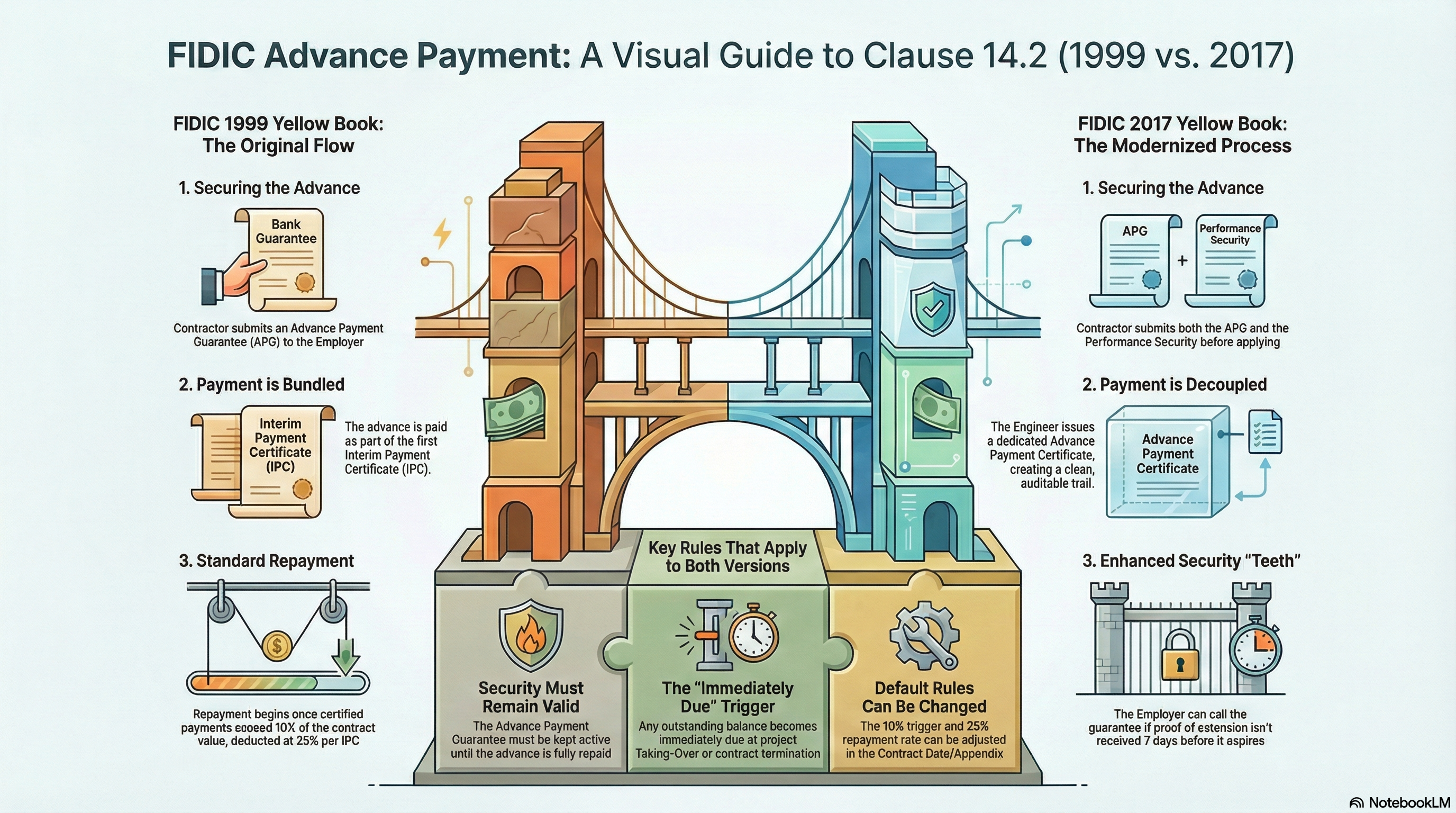

FIDIC Clause 14.2 — Advance Payment (Purpose & Protection)

Featured snippet — in plain words

Purpose of Clause 14.2 (why this exists and how it protects both sides)
Think of Clause 14.2 as the contract’s early-cash jump-starter. It lets the Employer front an interest-free sum so the Contractor can mobilize people, plant, temporary works, and kick off design without loading the Contract Price with expensive financing costs. In the 2017 Yellow Book, the purpose is explicit: the Employer pays, as an interest-free loan for mobilization and design, after an Advance Payment Certificate is issued and subject to the Contract Data stating the amount and currencies.

Why is this a big deal?
Contractor wins (cash-flow): Early liquidity arrives before the first big IPCs roll in. That means quicker procurement, faster mobilization, and fewer “cash valleys.”
Employer wins (security): Payment only flows against an Advance Payment Guarantee (APG), on-demand and kept valid until fully repaid. If the Contractor doesn’t extend a dated APG and the advance is still outstanding, the 2017 Book lets the Employer call the guarantee for the unrepaid balance (there’s a crisp 7-day rule—more below).

A key “scope switch”: if no advance amount is stated (Contract Data in 2017, Appendix to Tender in 1999), Clause 14.2 simply does not apply. ✔️

Contractor wins — cash arrives early
Liquidity for mobilisation & design
  • Procure long-lead items sooner; avoid “cash valleys.”
  • Lower financing baked into the Contract Price.
  • Confidence to ramp people/plant/temporary works.
Employer protected — on-demand APG
Advance Payment Guarantee stays alive
  • 7-day rule (2017): if the APG isn’t extended >7 days before expiry while any balance is outstanding, Employer can call for the unrepaid balance.
  • APG remains valid until the advance is fully repaid through deductions.
  • Engineer issues an Advance Payment Certificate before money flows.
Repayment visualizer (toy model)

Set a contract amount and your agreed advance % + repayment rules (illustrative). We’ll show how many IPCs it roughly takes to clear the advance.

10%
20%
25%
Advance amount: | Repayment begins when certified work reaches: | # of IPCs to repay:
Guardrails you must document
  • State the advance in Contract Data/Appendix (else 14.2 does not apply).
  • Define start-threshold + amortization rate (when deductions begin, how fast they run).
  • APG validity management — diarise renewal windows; align with programme slippage.
Common failure modes
  • APG lapses with balance outstanding → Employer can call (2017 7-day rule).
  • Mismatch between currencies/proportions in APG and Contract Data.
  • Repayment not synced with variations/downsizing → under- or over-recovery fights.
Sources & clause notes (highlighted)

Clause 14.2 — Breakdown of the exact moving parts (1999 & 2017)

Your step-by-step text (kept verbatim)

Clause 14.2 — Key Interpretations & Implications (risk reality)

What the words really mean for risk
A
Sequence clarity (2017’s biggest upgrade)
1999 bundled the first advance into the first IPC; 2017 decouples it into its own certificate with a 14-day issuance rule. That gives you a clean, auditable “APG → application → certificate → payment” chain—excellent for lenders and internal controls.
B
The “never let it lapse” doctrine
Both editions demand an unbroken APG. 1999 tells the Contractor to extend if 28 days ahead of expiry money is still outstanding. 2017 adds teeth: if evidence of extension isn’t received 7 days before expiry, the Employer can call the unrepaid amount. This is a crisp, objective trigger—no debate about “reasonable concerns.”
C
The math is deliberate
The default 10% trigger and 25% amortization are designed so a “typical” advance (≤ 22% of Accepted Contract Amount) is fully repaid by completion. FIDIC’s guidance notes highlight that assumption; if your advance is larger, tune the figures in Contract Data/Appendix to Tender.
D
Currency mirroring
Repayment must mirror the advance by currency and proportion. Multi-currency contracts need careful IPC setups; otherwise one currency might amortize faster than another and blow up reconciliations.
Advance proportions USD 60% EUR 70% Repayment mirrors these proportions per IPC
E
“Accepted Contract Amount” is a fixed anchor
Both editions peg thresholds to the Accepted Contract Amount (not the moving final price). Variations don’t shift the 10% trigger unless you change the Contract Data/Appendix. (Practically: if your advance is chunky and variations surge, consider revisiting the amortization profile in Particular Conditions.)

Clause 14.2 — Cross-references that really matter (hub & spokes)

Clause Filter:
ERP Mapping CSV:
Deep, friendly, super practical — kept verbatim

Clause 14.2 — Video explainers

FIDIC Clause 14.2 Explained: Advance Payments & Risk
APG basics • 10% trigger • 25% deductions • instant-due at TOC/termination

Clause 14.2 — What-If Scenarios (grounded, practical, no drama)

Your scenarios — kept verbatim
1
Scenario 1 — The APG has a calendar “expiry” and you’re not fully repaid

1999: Contractor must extend if still outstanding 28 days before expiry.

2017: Contractor must extend and send proof; if the Employer doesn’t get that proof 7 days before the expiry, the Employer can call the unrepaid sum under the APG.

Takeaway: Track APG dates like safety-critical items. Put diary alerts at T-42, T-28, T-10, T-7.

2
Scenario 2 — The advance is large (e.g., 30%)
The default 10%/25% rules may not repay in time. FIDIC’s own notes say the defaults presume advances < 22%. Adjust the “minimum amount to commence repayment” and “percentage deductions” in the Contract Data/Appendix to fit your cash curve.
30%
10%
25%
Advance amount: | Repay clears in ~ IPCs (after threshold)
3
Scenario 3 — Multi-currency contract
If your advance is 60% Local / 40% Foreign, every repayment must follow that exact split against each IPC. Configure ERP/valuation spreadsheets accordingly to avoid one currency lagging.
4
Scenario 4 — Payment timing
After the Advance Payment Certificate, the Employer pays within the specified period (default 21 days). Late? Financing charges under 14.8 kick in. That keeps cash neutral for the Contractor if the Employer’s treasury runs late.
5
Scenario 5 — Taking-Over hits with balance outstanding
The entire remaining advance becomes immediately due to the Employer (both books). Plan for it in your TOC cashflow.

Suggestions for Clarity & Improvement (Particular Conditions 💡) — Grid Layout

Context

Think of Clause 14.2 as a small, well-tuned engine. Your Particular Conditions are the ECU map that makes it purr under your project’s load. Below are “drop-in” options—each with (i) what to add, (ii) why it helps, and (iii) example wording you can adapt. I also flag interactions with 4.2, 14.3, 14.6–14.8, 15/16/18 (2017) or 15/16/19 (1999) so nothing fights the base text.

Clause 14.2 — Flowchart & Practical Resources

Download .html

Clause 14.2 — Email Templates Kit (grid)

Download .html
15 drop-in emails (FIDIC 1999 & 2017)

Click Copy, paste into your email client, and replace the [[placeholders]]. Use the filter box to search by clause or keyword.

1

Contractor → Engineer — Application for Advance (Initial)

✉️ 1) Contractor → Engineer Subject: Application for Advance Payment under Clause 14.2 (Initial Request) Refs: 14.2 (1999) / 14.2.2 (2017), 4.2, 14.3, 14.7 Dear [[Engineer’s Name]], Pursuant to Clause 14.2 (Advance Payment), we hereby apply for the advance as an interest-free loan for mobilization/design. In accordance with Clause 4.2 (Performance Security) and Clause 14.2.2 (Advance Payment Certificate, 2017), we confirm: The Performance Security has been provided (copy enclosed). The Advance Payment Guarantee (APG) has been issued in the amount and currencies stated in the Contract Data/Appendix (copy enclosed). Our Statement per **Clause 14.3 includes a line item for the advance and the subsequent repayment profile. Kindly issue the Advance Payment Certificate within 14 days (2017) and arrange payment within the period in the Contract Data (default 21 days) under **Clause 14.7. Attachments: Copy of Performance Security (4.2) Copy of APG (14.2.1) Statement extract (14.3) with currency proportions Bank details for receipt Yours faithfully, [[Name]], [[Position]] | [[Contractor]]
2

Contractor → Employer — APG & PS Submission

✉️ 2) Contractor → Employer Subject: Submission of APG & Performance Security (Pre-certificate compliance) Refs: 14.2.1, 4.2 Dear [[Employer’s Rep]], We enclose for your records the executed Advance Payment Guarantee (Clause 14.2.1) and Performance Security (Clause 4.2). Both instruments comply with the Contract forms and are issued by acceptable entities. This submission supports the Engineer’s issuance of the Advance Payment Certificate under **Clause 14.2.2. Attachments: APG; Performance Security; issuer confirmations. Kind regards, [[Contractor]]
3

Engineer → Employer — Advance Payment Certificate

✉️ 3) Engineer → Employer Subject: Advance Payment Certificate – Issue under Clause 14.2.2 Refs: 14.2.2, 4.2, 14.7 Dear [[Employer]], Having received (i) the Performance Security (4.2) and (ii) the APG (14.2.1), and (iii) the Contractor’s Statement (14.3), I hereby issue the Advance Payment Certificate for [[amount & currency split]] pursuant to Clause 14.2.2 (2017). Please arrange payment **within 21 days (unless a different period is stated in the Contract Data) per **Clause 14.7. Regards, [[Engineer]]
4

Contractor → Engineer — Request Tranche-2

✉️ 4) Contractor → Engineer Subject: Request for Second Tranche of Advance (Milestone-based) Refs: 14.2 (Contract Data/Appendix conditions), 14.3 Dear [[Engineer’s Name]], As conditions for Tranche-2 under **Clause 14.2 are satisfied (approved Mobilization Plan, site establishment, insurances in force), we request certification of the second tranche. Attachments: Evidence per Contract Data; updated 14.3 Statement. Best regards, [[Contractor]]
5

Contractor → Employer — APG Extension Notice

✉️ 5) Contractor → Employer (cc Engineer) Subject: Extension of APG – 28 days before expiry (Clause 14.2.1) Refs: 14.2.1, 14.2; 28 days (both editions), 7 days (2017 evidence rule) Dear [[Employer’s Rep]], As part of our obligations under **Clause 14.2.1, we confirm the Advance Payment Guarantee has been extended. Evidence of extension and amended face value (reflecting repayments) is enclosed. This submission is made at least 28 days before the current expiry. Please confirm receipt; we note the 7-day evidence rule under the 2017 Book. Attachments: APG extension, revised schedule of face value vs outstanding. Yours sincerely, [[Contractor]]
6

Employer → Contractor — Reminder to Extend APG

✉️ 6) Employer → Contractor Subject: Reminder to Extend APG – 28 days / Warning of 7-day call right Refs: 14.2.1 (2017), 14.2 (1999), 14.7, 14.8 Dear [[Contractor]], We note your APG expires on [[date]]. Under **Clause 14.2.1, you are required to extend it if any part of the advance remains unpaid. If evidence of extension is not received at least 7 days before expiry, we may call the APG for the unrepaid amount. Please provide the extension evidence urgently. Regards, [[Employer]]
7

Employer → Guarantor Bank — Demand under APG

✉️ 7) Employer → Guarantor Bank Subject: Demand under Advance Payment Guarantee (Clause 14.2.1) Refs: APG terms; 14.2.1 To: [[Bank]] (Issuer of APG) We hereby demand payment of [[amount & currency split]] under the Advance Payment Guarantee issued on [[date]] for [[Contract]]. The Contractor failed to furnish evidence of extension not later than 7 days before the guarantee’s expiry and advance remains unrepaid. Please remit funds to: [[account]] within [[on-demand timeframe per APG]]. Signed, [[Employer]] (as Beneficiary)
8

Contractor → Engineer — Repayment Commencement

✉️ 8) Contractor → Engineer Subject: Commencement of Repayment – Cumulative certified exceeds 10% Refs: 14.2/14.2.3, 14.3 Dear [[Engineer]], Cumulative certified interim payments have now exceeded 10% of the Accepted Contract Amount (less PS). In line with **Clause 14.2/14.2.3, please apply deductions at 25% of each IPC, by currency and proportion of the advance, from IPC [[#]] onward. Attachments: Calculation sheet; Statement 14.3 extract. Sincerely, [[Contractor]]
9

Contractor → Employer — Adjust Repayment Profile

✉️ 9) Contractor → Employer (cc Engineer) Subject: Proposal to Adjust Repayment Profile (Cash-flow alignment) Refs: 14.2/14.2.3, Contract Data/Appendix; agreement clause Dear [[Employer’s Rep]], Due to front-loaded procurement, we propose to adjust the repayment profile under **Clause 14.2.3 from 25% to a tapered schedule (30% until outstanding falls below 5% of ACA; then 15%). This preserves full repayment before Taking-Over (10.1) while smoothing cashflow. Please confirm if you agree to record this in the Contract Data/Appendix by addendum. Regards, [[Contractor]]
10

Employer → Contractor — Misapplication & Cure

✉️ 10) Employer → Contractor Subject: Notice of Misapplication of Advance & Instruction to Cure Refs: 14.2; Particular Conditions (use-of-funds & cure); 14.6/14.7 Dear [[Contractor]], Our review suggests portions of the advance were used for items outside mobilization/design. Please provide your ledger and supporting invoices within 7 days. Pending verification, we instruct the Engineer to increase repayment deductions to [[x]]% of each IPC until the misapplied amount is neutralized, consistent with the Particular Conditions. Failure to cure may lead to further remedies, including set-off. Regards, [[Employer]]
11

Contractor → Engineer — Multi-Currency Correction

✉️ 11) Contractor → Engineer Subject: Multi-Currency Repayment Correction Refs: 14.2/14.2.3, 14.3 Dear [[Engineer]], We note IPC [[#]] applied advance repayments not strictly pro-rata to the advance currency split. Under **Clause 14.2.3, please correct future IPCs so each currency repays in the same proportion as received. A reconciliation is attached. Thank you, [[Contractor]]
12

Contractor → Engineer — Pre-TOC Residual Plan

✉️ 12) Contractor → Engineer (cc Employer) Subject: Pre-TOC Residual Advance Plan (Zeroing before 10.1) Refs: 14.2.3, 10.1, 14.3 Dear [[Engineer]], With Taking-Over approaching under **Clause 10.1, we enclose a schedule showing the residual advance and the deductions required to reduce it to zero before TOC. Kindly reflect this plan in the penultimate and final IPCs to avoid the immediate-due call at TOC. Attachment: Residual advance schedule. Sincerely, [[Contractor]]
13

Employer → Contractor — Immediate Repayment at TOC/Termination

✉️ 13) Employer → Contractor Subject: Immediate Repayment of Outstanding Advance at Taking-Over / Termination Refs: 14.2/14.2.3, 10.1, 15/16/18 (2017) or 15/16/19 (1999) Dear [[Contractor]], As of Taking-Over (**Clause 10.1) / termination (**Clause 15/16/18), an outstanding balance of the advance remains. Under **Clause 14.2/14.2.3, the entire balance is immediately due. We will set off against sums certified and, if necessary, draw on the APG. Please remit the remainder within [[x]] days. Regards, [[Employer]]
14

Contractor → Employer — Replacement APG (Downgrade/Sanctions)

✉️ 14) Contractor → Employer (cc Engineer) Subject: Replacement APG due to Issuer Downgrade/Sanctions Refs: 14.2.1; Particular Conditions (issuer quality) Dear [[Employer’s Rep]], The current APG issuer has been downgraded/is affected by sanctions. In line with the Particular Conditions and **Clause 14.2.1, we attach a replacement APG from an acceptable issuer. The former APG will be cancelled upon your confirmation. Attachments: New APG; issuer certifications. Best, [[Contractor]]
15

Contractor → Engineer — Bank Details & Payment Logistics

✉️ 15) Contractor → Engineer Subject: Payment Logistics & Bank Details for Advance Refs: 14.2, 14.2.2, 14.7, 14.8 Dear [[Engineer]], Further to the Advance Payment Certificate, please find our bank coordinates for receipt. Kindly remind the Employer of the payment period under **Clause 14.7 (default 21 days) and financing charges for delay per **Clause 14.8. Attachment: Bank details letter on company letterhead. Sincerely, [[Contractor]]
